Douglas County is excited to be partnering with Clarion Associates to conduct a comprehensive diagnostic review of the County’s zoning and subdivision regulations. These are the policies that direct how and where development occurs in the unincorporated area of the County.

The goals of this project are to:

  • Improve clarity, structure, and usability of the land use regulations for both staff and applicants;
  • Identify strengths and weaknesses in the current regulations, including outdated or restrictive standards that may hinder housing, economic, or agricultural development;
  • Evaluate how the zoning and land use regulations do (or do not) align with adopted comprehensive and area/specific land use plans;
  • Assess administrative processes under the City/County planning agreement;
  • Identify opportunities for alignment and enhancement between land use regulations and adopted policies and processes; and
  • Provide strategic, actionable recommendations to modernize the zoning and land use regulations and support future updates.

Project Timeline

Timeline of the Project

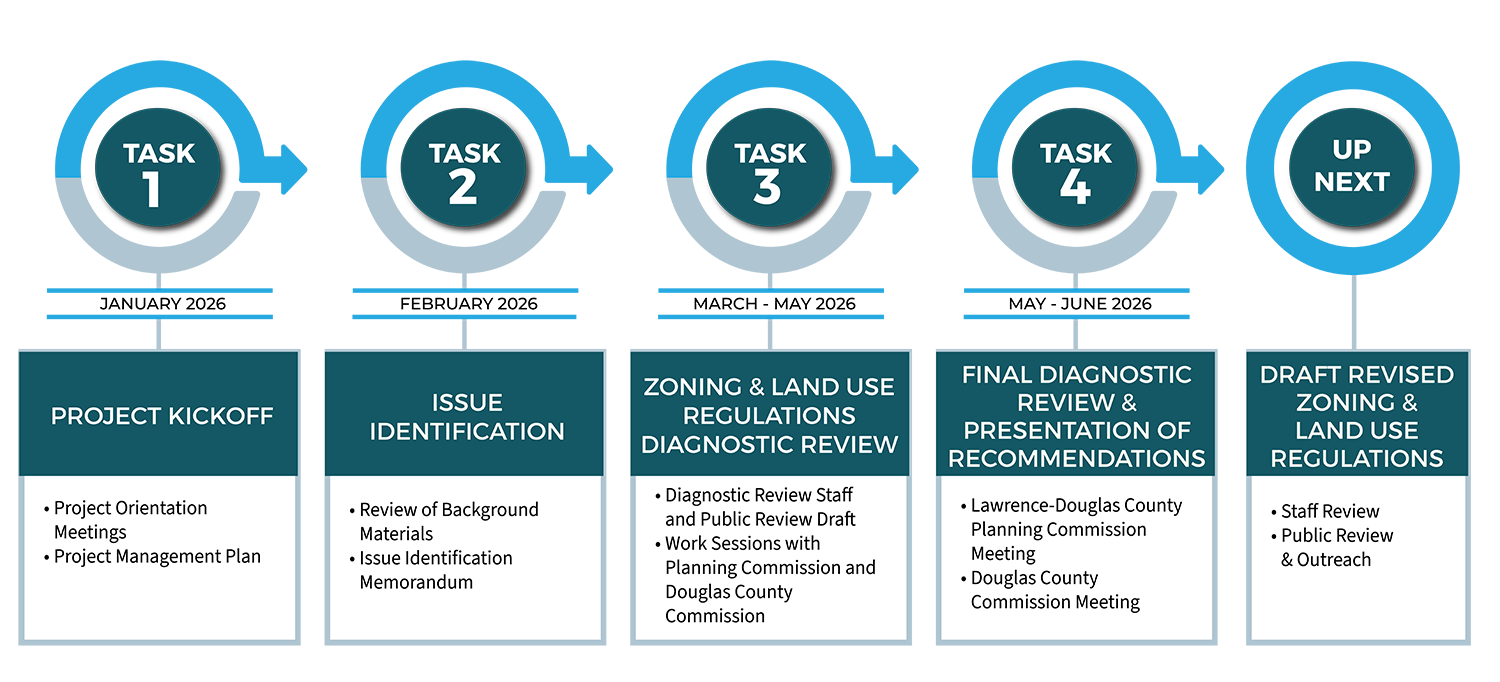

Timeline image of the project
Timeline overview of tasks, dates and key activities (January - June 2026)
Timeline overview of tasks, dates, and key activities (Jan–Jun 2026).
TaskTimelineTitleKey Activities
Task 1January 2026Project Kickoff
  • Project Orientation Meetings
  • Project Management Plan
Task 2February 2026Issue Identification
  • Review of Background Materials
  • Issue Identification Memorandum
Task 3March – May 2026Zoning and Land Use Regulations Diagnostic Review
  • Diagnostic Review Staff and Public Review Draft
  • Work Sessions with Planning Commission and Douglas County Commission
Task 4May – June 2026Final Diagnostic Review & Presentation of Recommendations
  • Lawrence–Douglas County Planning Commission Meeting
  • Douglas County Commission Meeting
Up NextAfter June 2026Draft Revised Zoning and Land Use Regulations
  • Staff Review
  • Public Review and Outreach

Latest Updates

Upcoming Meetings

County and Clarion staff will be presenting at the Board of County Commissioners on July 15th at 5:30 PM at the Historic Court House. You can access the agendas and instructions on how to participate here: Board of County Commission Meeting Agenda

How to Get Involved
